Friday Recap November 28th, 2025
U.S Representative district 7
We all need to get behind our Republican candidate Matt Van Epps as this is not a lay down election. The Democrats are well organized and energized. As I mentioned earlier, the vote differential between Republicans and Democrats in the recent primary was only 18%, 36,854 Republicans to 31,002 Democrats for a difference of only 5,852 votes. The Democrat establishment is zeroing in on this election and if they can flip this seat to blue, it will change the dynamic in Washington and give the Democrats a win that will reverberate around the country. We cannot let this happen.
Van Epps' opponent, Aftyn Behn, more Aftyn, more Aftyn and one more is a leftist who would fit right in with AOC and her cohorts. She literally hates Nashville.
How you can help
The Williamson County Republicans Door Knocking tomorrow November 28th at 9:00 am.
Address: 130 Seaboard Ln, Franklin, TN 37067
Tent greeters needed for election day December 2nd. Call the office to sign up for one of the election sites.
Pole Watchers needed for election day December 2nd. Sign up here

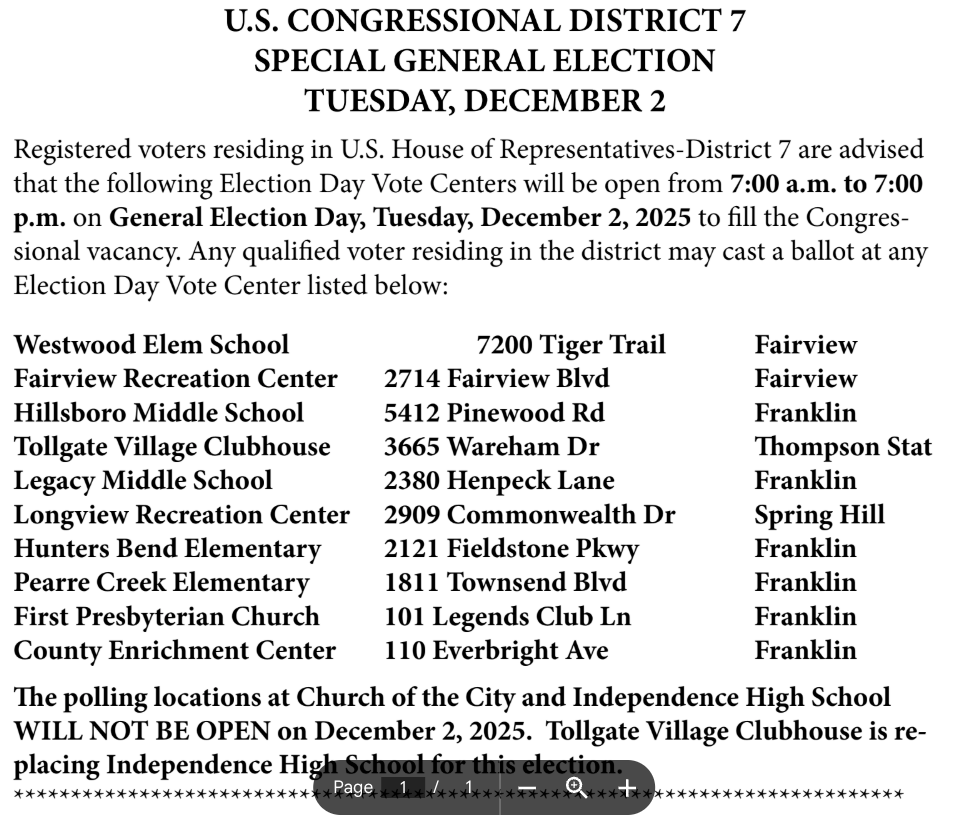

Election Day: Dec. 2
If you have any questions contact the Williamson County Election Commission at 615-790-5711.
Rally in Franklin for Van Epps on Monday, December 1st

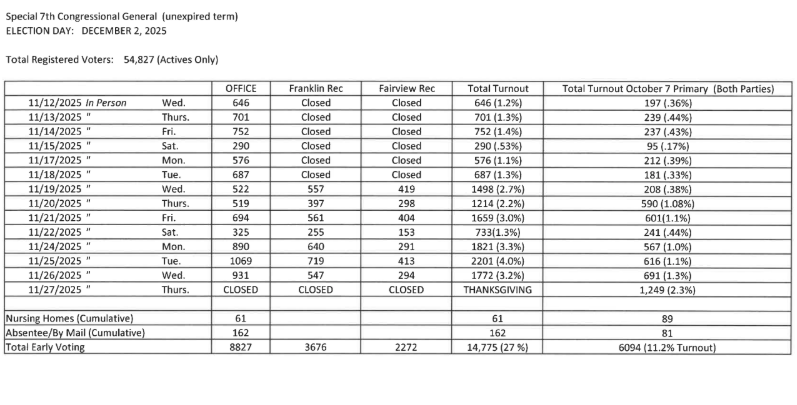

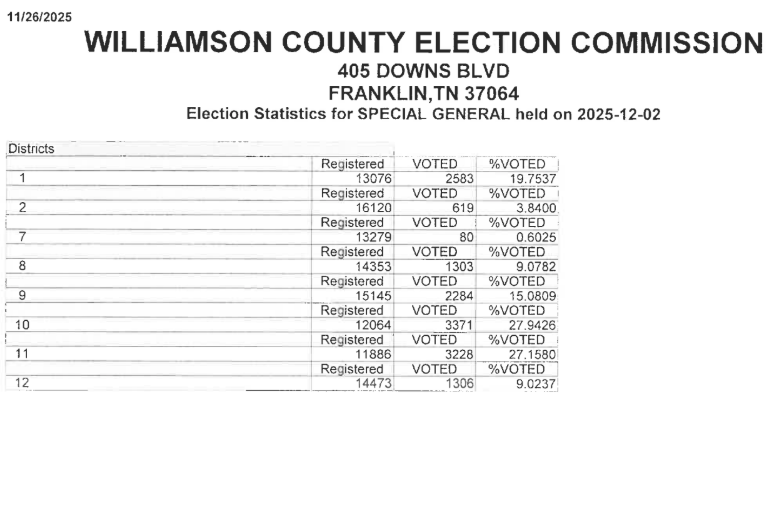

Early voting Results as of Wednesday
Eight of the twelve districts in Williamson County are also in District 7 for U.S. Representative. I am listing the % of votes from each district as well as the total number of votes for all eight in early voting.



BOMA is considering implementing Infrastructure development district policy
This is controversial, and we need to understand what all this means. BOMA discussed a draft of this policy for the city of Franklin in their last Work Session (see below in my report) and will be revisiting it at their December 9th meeting. For now, this is a link to the draft of their policy, Infrastructure Development Districts. I will have more next week.
https://www.thegatewaypundit.com/2025/11/watch-far-left-dem-congressional-candidate-tennessee-turns/
https://www.thegatewaypundit.com/2025/11/watch-far-left-dem-congressional-candidate-tennessee-turns/
- Enjoying Friday Recap? Take a minute now and forward it to 3 people. Copy this https://friday-recap.ghost.io/ghost/#/editor/post/680aad97ab206e0001e15b3f in your email.
The AI program I use is pretty accurate, but it does make mistakes from time to time and I don't always catch them. I provide agendas and videos/audios when I have them available and recommend that you watch the video and follow along with the summary to get the most accurate report.
One of the limitations of AI is that if a participant's name is not called out, then they are listed as participant 1, 2, etc. A limitation with audio, as opposed to video, is that one cannot always identify a person by voice alone. As imperfect as these AI summaries are, they still give a pretty good account of a meeting.
Williamson County School District
The only meeting in December is the Policy Committee meeting that will be held on December 15th. I will have information on that once it's published by WCS.
Williamson County Commission
Monday November 24th
The Education Committee Agenda Audio Committee members: Steve Smith (C), Bill Petty (VC), Chris Richards, Drew Torres, Judy Herbert. Commissioner Richards was absent.
AI Summary
Overview
- Committee accepted Williamson County Schools' five-year capital plan for submission to county government in January
- Proposed funding needs for FY25-26 dropped from $143M to $61M compared to last year's plan
- School board accelerated Split Log middle school timeline against administration's recommendation, moving $17M in site development from FY26-27 to FY25-26 for projected fall 2029 completion
- Total five-year projected needs decreased by $316M compared to prior year's plan
- Plan includes LED field light upgrades for all 9 high schools and ongoing physical/cyber security infrastructure improvements
- Current school debt sits around $600M with potential to double over next 5 years, though $94-97M is available in education impact fee funds
Five-year capital plan overview
- Jason presented the proposed capital plan with reorganized structure: real estate, new buildings, additions/renovations, then maintenance
- Administration moved all new construction projects to the new buildings section, leaving only renovations in the second section
- Committee received hard copies of current five-year plan for comparison to proposed version
Split Log middle school timeline
- School board voted to accelerate middle school timeline against administration's original recommendation
- Administration proposed fall 2030 completion with site development funding in FY26-27
- Board amended to move $17M site development to FY25-26 for fall 2029 completion
- Site requires extensive rock work and site preparation
- Administration reasoning for delay: Woodland, Sunset, and Mill Creek middle schools still have capacity
- Board reasoning for acceleration: Mill Creek Middle already full and encroaching on Mill Creek Elementary space, concerns about 2029 vs 2030 opening with growing middle school enrollment
- Jason recommended approval of board's amendment because capital plan should alert county government to needs earlier rather than later to avoid surprises
LED field light upgrades
- Plan includes replacing metal halide field lights with LED lights at all 9 high schools
- Old metal halide lights require bucket trucks on fields for repairs, causing potential turf damage
- Last ESCO (energy savings) evaluation showed field lights don't consume enough energy to fund replacement through energy savings alone
- Project timeline depends on contractor availability and field use schedules—likely won't complete all schools in one year
- LED lights provide longer lifespan and reduced maintenance costs with modest energy savings
ALC relocation to 300 Beasley
- County government proposed moving Alternative Learning Center to bottom floor of 300 Beasley building
- Jim Cross's company Oversight is designing mezzanine space and upper floor offices
- Schools plan to move 4-person safety department from E911 building to new office space
- Additional office space will be available but exact number of offices depends on final design
- Project will increase ALC student capacity beyond current levels
- County government may fund project using education impact fee funds given capacity increase
Physical and cyber security infrastructure
- Annual requests of $12-15M represent third year of multi-year fobbing project for school door access control
- FY25-26 will finalize door fobbing installation across all schools
- Projects also include intercom and radio replacements on replacement cycles
- Commissioner Torres requested macro-level breakdown of security projects for better transparency
- Jason emphasized security improvements will be ongoing indefinitely as threats evolve and new safety measures emerge
- State employee assigned to Williamson County and Franklin Special schools provides guidance on prioritization
- Current priority is hardening building access with electronic controls; panic buttons may be future consideration
School renovations and aging buildings
- Grassland Middle School renovation included in plan—building opened in 1986 (now 40 years old)
- Renovation focuses on infrastructure modernization: door replacements, ductwork, HVAC, ceiling tiles, cabinetry
- Renovations aren't cosmetic facelifts but necessary infrastructure updates for aging buildings
- Schools at ~70% capacity still use nearly all classroom spaces due to state-required services like Response to Intervention that didn't exist 40 years ago
- Franklin High and Fairview press boxes/facilities identified as aging but not yet prioritized for renovation funding
- Discussion about whether to renovate entire buildings when enrollment is below capacity—administration's position is to modernize full infrastructure since all spaces remain in use for required services
Funding mechanisms and debt concerns
- Current school system debt approximately $600M with potential to double over next 5 years based on projections
- Commissioner noted $94-97M currently available in education impact fee funds
- Impact fees can fund new buildings, additions to existing schools, and projects like ALC relocation
- Commissioner Torres advocated for moving recurring items like asphalt, HVAC, and roofs into operational budget rather than debt financing
- Bus purchases now funded through fund balance rather than capital plan
- Administration acknowledged total five-year projection "can feel overwhelming" but emphasized $316M reduction from prior year
- Chemistry class fundraising clarification: Ravenwood's communication incorrectly suggested $3,500 per class was required; administration clarified base needs are budgeted and donations are voluntary to enhance quality beyond baseline
Tuesday December 2nd
The Opioid Abatement Taskforce will meet at 1:30 pm in the Executive Conference Room of the Williamson County Administrative Complex at 1320 W. main, Franklin. I have no further information.
Wednesday December 3rd
The Highway Commission will meet at 8:30 am in the Williamson County Highway Facility 302 Beasley Drive, Franklin. I have no further information.
Special Note: Since Williamson County does not record any meetings other than the commission, budget committee and planning commission meetings, I am recording all the meetings that I attend on my iPhone. Starting on January 1, 2026, all county committee meetings will be recorded and posted on the county website.
Board of Mayor and Aldermen
Tuesday November 25th
BOMA Work Session Agenda Video
AI Summary
Overview
- Board reviewed $3.48M subsidy request for Busque Place to create 44 units (10 affordable, 34 workforce housing) with strong support from multiple aldermen despite the price tag
- City authorized moving forward with $118M general obligation bond issuance for capital projects including $85M for new City Hall, fire apparatus, road resurfacing, and Pearl Bransford Park/Robinson Lake completion
- Emergency Hobas pipe repair at Ewingville Drive requires $1.45M change order with total project cost around $7.7M, funded through sewer fund balance and budgetary savings without issuing new debt
- Board provided extensive feedback on draft infrastructure development district (IDD) policy, with concerns the framework is too bureaucratic and may discourage developer participation while others emphasized need for clear public benefit requirements
- City Hall redevelopment tracking for fall 2027 completion at $94.7M adjusted cost after absorbing $2.4M in additional subsurface work
Harlinsdale Farm workers' houses restoration
- City and Friends of Franklin Parks entered lease agreement for 2 worker houses at Harlinsdale Farm park along main drive
- Partnership structured as 50-50 match similar to historic Hayes home agreement, with city paying for infrastructure and utilities
- Friends of Franklin Parks leases properties at discounted rate for 18 years with two additional 5-year extensions in exchange for capital funding contribution
- Friends contributing to restoration costs and can rent facilities for events, with spaces also available for general public and city staff during large special events
- Houses built in 1950s for farm workers, approximately 600 square feet each
- One house gutted and will be rebuilt as smaller meeting space, second house has existing kitchen and restroom being restored
- All 4 worker houses on property will eventually be restored under National Historic Registry requirements with interpretive signage
- Project aims to tell stories of people who worked at Harlensdale Farm and activate the campus for community benefit
Busque Place affordable and workforce housing
- Hill LLC proposed 44-unit development (increased from original 33 units) with subsidy request of $3,480,590
- Unit breakdown: 10 affordable units for families at 80% or below area median income, 34 workforce units for families at 80-150% of median income
- Per-unit subsidy: $65,000 for workforce units, $125,000 for affordable units in 44-unit scenario
- Funding breakdown: $1.5M for infrastructure investment, $479,700 land reimbursement from water management, $600,000 from future CDBG allocations, plus development fee relief from Title 21
- County originally pledged $1M in ARPA funds but has since reprogrammed those dollars
- LLC invested $250,000 of their own funds and reduced administrative fee from 6% to 2% (saving $700,000-$800,000) to close funding gap
- Partnership includes Pinnacle for construction loan and Housing Fund of Nashville committed to purchase 10 houses upfront at $365,000-$375,000 range
- All units will be deed restricted in perpetuity to maintain affordability, with restrictions renewed each time property changes hands
- Board expressed strong support with Alderman Blanton emphasizing need for bold action on housing crisis, Alderman Potts highlighting 47% of workforce cannot afford to purchase homes in Franklin
- Alternative option discussed: convert all 10 affordable units to workforce would reduce subsidy from $3.5M to under $3M but would lose $600,000 CDBG funding
- Project team already spent approximately $150,000 on plans and design work over 5-6 years of development
- Development named "Busque Place" after Brandt Busque who championed the project
City Hall commercial tenant selection criteria
- Three potential tenant spaces along Third Avenue South between City Hall and new public park totaling approximately 4,500 gross square feet
- Two outer spaces slightly larger than middle space, outer two can accommodate full kitchens, middle space limited kitchen
- City plans to issue RFQ for licensed commercial brokerage firm and property manager starting next week through end of year, return in spring with recommendations
- Broker will market spaces, collect letters of interest, conduct financial vetting, and present tenant mix to board for approval based on criteria
- Draft tenant criteria emphasizes: engaging spaces complementing historic downtown and park, activating Third Avenue streetscape, serving residential neighborhoods and city hall uses, locally owned businesses, continuous daytime activity avoiding hours past 10pm, no alcohol/smoke/vape product sales
- 2022 market analysis by Gibbs Planning Group identified potential uses: small gourmet market, bookstore, florist, bakery, coffee shop, specialty foods, boutique pharmacy, 2-4 small restaurants
- Board feedback strongly emphasized local ownership over chains, fast-casual dining or sandwich shops that complement park use without competing with existing downtown businesses
- Alderman suggested surveying downtown residents, CVB, merchants, hotel, courthouse workers, and city staff to identify missing services
- Vice Mayor stressed using spaces to support local tenants being squeezed out of Main Street, avoiding "mall-like" tenancy, and potentially creative solutions for smaller local businesses
- Alderman Brown noted DNA survey less than 3 years old showed NY Deli as top response for desired tenant type
City Hall block redevelopment update
- New building: 97,000 square feet, three stories, underground parking garage with approximately 200 spaces
- Includes improved community plaza at square, Third Avenue streetscape, one-acre park, upgraded utilities
- Construction broken into Area A (under building) and Area B (under park area)
- Total of 172 piers for both areas, with 18 piers remaining in Area B to be completed by end of next week
- Parking garage slab pour starts next week in Area A, columns already visible
- ERPs 1 and 2 originally estimated over $30M, actual cost $27.5M
- Additional work authorization of $2.4M required for unforeseen subsurface conditions (deeper pilings needed as rock wasn't in good condition), expected actual cost $1.5M
- Project had $3.2M in under-project budget going into additional subsurface work, using approximately half to address piling depth issues
- Adjusted GMP now $94.7M including the $2.4M addition
- Design spending to date: $7M, construction spending to date: $8.5M as of earlier this month
- ERP3 bids received and under review, tracking at or below anticipated costs, expected finalization second week of December
- Project completion targeted for fall 2027 (late summer/fall)
- City Hall will receive new address 299 Public Square (nod to 1799 founding) as main entrance returns to square side, commercial tenants will get addresses in 115-119 range on Third Avenue
General obligation bond issuance
- Board authorized moving forward with bond issuance of not to exceed $118M in aggregate principal amount
- Project funding breakdown: fire apparatus (3 replacement pieces ordered almost a year ago, delivery expected calendar year 2027), major road resurfacing $7.5M for 2 paving seasons (2026 and 2027), Pearl Bransford Park/Robinson Lake $15M to finish debt funding, Long Lane Road improvements, Church Street Road improvements (early stage design and ROW acquisition), new City Hall $85M
- Bonds secured by full faith and credit of City of Franklin with AAA credit ratings from two agencies
- Financing team: Bassberry and Sims (tax exempt opinion), PFM (financial advisor), Moody's and Standard and Poor's (ratings), US Bank (paying agent), underwriter TBD through competitive sale
- Estimated true interest cost approximately 4% based on recent market rates (was closer to 4.50% in summer)
- Final maturity 2051 (25 years out), with varying amortization schedules: fire engines and road resurfacing shorter term, City Hall 25 years, Pearl Bransford Park/Church Street/Long Lane 20 years
- Current outstanding GO debt: $132M as of June 30, 2025 with final maturity 2045
- Debt service front-loaded and stair-stepping down over time rather than pushing principal out
- City less than 40% (closer to 30%) dependent on debt in 10-year CIP, using debt strategically for long-term benefit projects
- This is first GO debt issued in nearly 6 years
- Timeline: Board consideration December 9th, credit rating agency meetings early January, public market mid to late January after ratings finalized, closing anticipated mid-February
- City using reimbursement resolution approved in May to account for City Hall expenses until bond close in February
Hobas pipe emergency repair and funding
- Emergency repair required for 48-inch FRP Hobas pipe at Ewingville Drive with change order to Garney Construction for $1,452,381.52
- Timeline of Hobas failures: June 2014 first break (230 feet near Pinkerton Park, attributed to underground spring), 2017 major failure behind Chestnut Bend (lined pipe under river, replaced most with ductile iron toward wastewater plant), fall 2024 Chestnut Bend sinkhole (neoprene boot failure at manhole), April 2025 Ewingville sinkhole discovered
- Ewingville project replacing colored sections showing various damage: longitudinal cracks allowing groundwater intrusion, vertical cracks, complete soil infiltration
- Pipe deflection measurements from 2018 report showed 18-20% deflection in some areas vs. Hobas-allowed 5%, making sections unlineable
- Project expanded from spot repairs to replacing all damaged sections totaling approximately 300 feet additional pipe beyond original scope
- Chestnut Bend repair completed, some restoration work remaining (seeding dependent on weather), will return in spring for additional seeding
- Ewingville construction in progress with 30-foot deep excavation in Cromwell cornfield area, completion expected June 2026
- Total project costs: bypass pumping incurred to date approximately $400,000, costs to be incurred through completion approximately $150,000-200,000 range, temporary construction easements secured from 5 property owners (Storbridge neighborhood properties plus Cromwell cornfield)
- Change Order 1 (current board item): $1,452,381.52 for additional 300 feet of pipe replacement and reclaim bypass setup through March
- Change Order 2 (expected January board meeting): transfer of bypass pumping costs to Garney, establish project completion deadline with liquidated damages provision
- Garney providing credits: reducing Chestnut Bend manhole repair cost by half (from $225,000 to $112,500), providing 3 weeks free bypass pumping, second manhole repair for free due to delays and errors in Chestnut Bend work
- Reclaim water system bypass established to serve Berry Farms during construction, may shut down during wet season and restart March/April depending on weather and rental costs
- Total estimated project cost range $7-8M funded through: budgetary savings from sewer operating fund (CIPP and routine replacement/repair funds), $479,700 payment from General Fund for Pearl Park land ownership transfer to Parks, $7M from sewer fund balance (analysis shows can stay above state required minimum reserves and MTAS recommendations)
- City to perform cost of service analysis and rate study after Ewingville completion to ensure revenue sufficient for broader Hobas replacement strategy and maintain debt service coverage
- Next phase: evaluation and prioritization of remaining Hobas pipe in system to determine what can be lined vs. requires excavation and replacement, maximize CIPP lining as cost-effective strategy
Infrastructure development district policy
- Board reviewed draft policy framework establishing procedures for considering petitions to create real estate infrastructure development districts
- Policy focuses on 4 priority pillars for community benefit: exceptional development, infrastructure development, attainable housing, and redevelopment
- Process requires developers to submit notice of intent (5-page form mirroring tax increment financing requirements) followed by draft petition
- 60-day maximum period for staff and developer to work through notice of intent and draft petition before developer can file formal petition
- After petition filed, city posts notice on website, developer notifies residents by mail, public hearing held at regular Board of Mayor and Aldermen meeting (estimated 1-5 month timeline from start to approval)
- Policy establishes 3:1 value-to-lien ratio as strong preference vs. 2:1 state minimum, with flexibility built in (not rigid requirement)
- Special assessment bonds issued through conduit issuer (not city directly) to protect AAA credit rating, no general obligation pledge from city
- Financing team (through conduit issuer) includes separate bond counsel, financial advisor, underwriter, and trustee handling special assessment revenues
- Policy allows both reimbursement bonds (after infrastructure approved) and construction bonds (upfront), though reimbursement preferred
- Municipal benefit guidelines attached as Exhibit D with sample commitments across 4 categories, not rigid checklist
- Staff recommendation threshold: at least one category meets "full credit" level, one additional category at least partially addressed
- All units in districts will be deed restricted in perpetuity to maintain intended use/affordability
- Transparency requirements: annual reporting to board on district progress, notice of district creation filed with Williamson County Register of Deeds
- Administrative fees up to 5% of special assessment revenues to cover city costs
- Policy allows board flexibility to amend or waive provisions by resolution when approving specific districts
- Board raised significant concerns policy is over-engineered and too bureaucratic, may discourage developer participation
- Alderman Brown emphasized: tool should be market-driven like Texas model, not tied so closely to zoning/final site plans, reimbursement-only preference favors large cash-rich developers over local developers, concerned about staff recommendation creating conflict with board priorities
- Vice Mayor Baggett emphasized: wants stringent criteria as starting point with understanding board can waive, concerned about requests that simply finance normal impact fees and infrastructure without real public benefit, wants two-acre school site example balanced against IDD funding amount
- Alderman Barnhill expressed concern about tying too closely to final development plans, kills negotiation opportunity to influence project design
- Alderman Potts emphasized maintaining conservative 3:1 ratio focus for long-term AAA bond rating protection
- Alderman Caesar stressed need to avoid acceleration of growth, ensure this funds things beyond minimum requirements, acknowledged development community sees this as "financial bonanza" requiring real public benefit in return
- Multiple aldermen emphasized cannot be just impact fee financing tool, must deliver extraordinary community benefit
- Critical blocker identified: city not yet "host municipality" under state law because no agreement with Williamson County for collecting special assessments, County Trustee needs software upgrade
- County Trustee attorney raised potential issue requiring legislative cleanup bill that could delay implementation
- County attorney wants separate interlocal agreement for special assessment collection between city and county
- Board directed staff to prioritize confirming county will support interlocal agreement before spending more time on policy development
- Item will return to board work session December 9th for continued discussion with more time allocated on lighter agenda
- Board requested new City Hall tenant addresses (299 Public Square) not be printed on materials until closer to building opening
BOMA Board Meeting Agenda Video
AI Summary
Overview
- Board deferred the controversial Columbia Avenue overlay district zoning amendment to January 13th, 2026 after procedural issues emerged around 21-day public notice requirements and fundamental disagreements over requiring a development plan
- HG Hill Company strongly opposed the amendment requiring development plan approval, stating they will not agree to rezoning their property and may withdraw if forced into that process
- Board approved $1,452,381.52 change order for emergency 48-inch fiberglass reinforced pipe repair on Unionville Drive
- Board approved legal representation contract for PFAS class action lawsuit on contingency fee basis
- December community events scheduled: tree lighting December 5th starting at 6:00 pm (ceremony at 6:40 pm, tree lights at 7:15 pm) and Christmas parade December 6th at 1:00 pm
Columbia Avenue overlay district zoning amendment
- Board deferred ordinance 2025-2075 to January 13th, 2026 due to public notice requirements after amendment was made at previous meeting
- City attorney explained the amendment added at last meeting requires another public hearing with 21-day advance notice, which cannot be met before the December 9th meeting
- Amendment would go back to Planning Commission in December before returning to board for final action in January
- Jimmy Granberry of HG Hill Company strongly objected to the amendment:
- Hill Company has been in Tennessee for 130 years (started 1895), Granberry represents 4th generation
- Company spent hundreds of thousands of dollars on planning and drawings with local architect Mike Hathaway
- Received unanimous approval from Board of Zoning Appeals to relocate hotel off back of property
- Received unanimous approval from Planning Commission after making requested changes (reducing hotel to three stories, adding 10-foot step back on third floor along Columbia Avenue)
- Development plan requirement was never discussed during year-long planning process
- Respectfully requested board remove any amendment requiring property rezoning or development plan
- Attorney John Cooper (Holland and Knight) argued the amendment is not consistent with Tennessee law:
- Amendment singles out one property and is arbitrary and unfair to developer
- Would require rezoning to planned development district, adding months of delay and jeopardizing project viability
- Developer followed all required processes and received unanimous approvals
- Alderman Baggett explained rationale for initiating the amendment:
- Applicant asked Planning Commission to recommend BOMA change zoning ordinance rather than going through PD rezoning process
- BOMA controls the zoning ordinance, not Planning Commission
- Referenced concerns from residents about heights and development on Folk Street side
- Cited precedent from margin district where promises about preserving Handy Hardware weren't kept (facade remains but building is gone)
- Emphasized this is BOMA's job to set zoning ordinance while Planning Commission sets Envision Franklin
- Development plan would provide what the board wants while just changing zoning ordinance provides no guarantees
- Planning staff clarified that reverting to current two-story limit would not allow three stories even through development plan process because Columbia Avenue overlay rules override PD district zoning
- Margin district received three-and-a-half stories through same process: Envision Franklin amendment followed by zoning ordinance change to allow by-right development
- Current zoning ordinance change is specifically for this property to match the Envision Franklin Plan Amendment from September Planning Commission meeting
- Development plan process would include joint conceptual workshop, neighborhood meeting for adjacent property owners, and much more public input
- Granberry stated clearly that if board requires development plan/rezoning route, Hill Company will withdraw rather than agree to rezoning
- Motion to defer passed 6-2 (Aldermen Barnhill and Peterson voted no)
Upcoming December city events
- Christmas tree lighting event December 5th at 6:00 pm with formal ceremony starting at 6:40 pm and tree lighting at 7:15 pm
- Matthew West is helping with the event again and Freedom Intermediate choir will perform
- Annual Christmas parade December 6th at 1:00 pm with Downtown Rotary assisting
- Special work session scheduled December 5th for board members to experience downtown trolley service
- Free transit runs 11:00 am to 2:00 pm from downtown with stops at Transit Center, town square, and the factory with return service
Housing study recognition
- Mayor acknowledged and thanked Williamson County Association of Realtors for investing in significant housing study shared with public last week
- Study is available on WCAR website
- Study identifies housing shortage for variety of housing types in community, projected over next few years
- Bo Patton specifically recognized for his work on Housing Commission and carrying study forward to WCAR, helping present it last week
Unionville Drive emergency pipe repair change order
- Board approved change order one to contract number 2025-0174 with Garney Construction
- Change order amount is $1,452,381.52 for emergency 48-inch fiberglass reinforced pipe repair
- Motion passed unanimously 8-0
PFAS lawsuit legal representation contract
- Board approved contract number 2025-0532 with Stag-Louisa, LLC for legal representation in PFAS class action lawsuit
- Contract is on contingency fee basis
- Motion passed unanimously 8-0
For all other meetings this week and next go here
Election Commission
No meetings this week or next
If not me, who?
If not now, when?
“Now faith is the substance of things hoped for, the evidence of things not seen (Heb. 11:1)
“We work hard with our own hands. When we are vilified, we bless; when we are persecuted, we endure it; when we are slandered, we answer gently.” (1st Corinthians 4:12-13)
"Do nothing out of selfish ambition or vain conceit. Rather, in humility value others above yourselves" (Philippians 2:3)
Blessings,
Bill
Community resources
If you like Friday Recap, check out these other grassroots conservative projects!
- Grassroots Citizens of Williamson County Provides free tools and information to help grassroots conservatives exercise their citizenship here in Williamson County.
- Tennessee Voters for Election Integrity is helping restore confidence in Tennessee Elections.
- TruthWire Local news and commentary.
- Williamson County Republican Party is one of the most active parties in the state and captures the conservative heart of Tennessee.
- Mom's For Liberty Williamson County is dedicated to fighting for the American family by unifying, educating and empowering parents to defend their parental rights at all levels of government.
- Tennessee Stands produces video media, podcasts, and live events, and provides social commentary on relevant issues in our state.
- M4LU is a new site developed by the national Mom's for Liberty but generated right here in Williamson County. The mission of M4LU is to to inform, equip, and empower parents with knowledge, understanding and practical tools.
Help educate citizens of Williamson County
Want to support Friday Recap? Forward this newsletter to 3 people and invite them to subscribe. Use this link
Was this newsletter forwarded to you? Subscribe now by clicking below.
